week 22

Current projects

Solstice Park

Solstice Park, a £250 million development on a 160 acre (65 hectare) site, is one of the largest mixed-use business parks in central Southern England. Strategically located adjacent to the A303 trunk road, Solstice Park provides unrivalled transport links. Find out more www.thecrescentoffices.com

Sunstone Construction Ltd were appointed main Design & Build Contractor to construct the C2 Office Development on Solstice Park.

The design and construction of the buildings has focused on low energy solutions that were conceived on the basis of avoiding the need for comfort cooling/air conditioning, thereby minimising the carbon footprint, energy consumption and energy costs. The principle features of the buildings from this respect are:-

As well as enabling the buildings to achieve a level of performance that satisfies the latest Building Regulations (Part L, 2006), the incorporation of such a design philosophy should enable the buildings to achieve 'Good Practice' energy ratings, as listed in the Carbon Trust 'Best Practice Programme' publication ECG 19 'Energy Use in Offices'. This should result in the annual energy consumption and carbon emissions being just 30% of a comparable 'typical' air conditioned building.

On completion of the buildings, independent air permeability tests (a measure of there air tightness with all windows and doors closed) have shown the buildings to be better than the 'best practice' levels described in the British Council for Offices Guide 2005 - Best Practice in the Specification for Offices.

Click on an image to enlarge it:

Solstice park

Week 42 —Phase 1 completed

Solstice park

Week 35 — Finishes & external paving in progress

Week 30 — Cladding & curtain walling complete to both buildings

Week 25 — block A curtain walling complete & weather tight

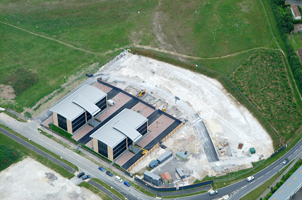

Week 22 — roof water tight and curtain walling in progress

week 18

Week 18 — pre-cast floors and roofs completed & external envelope commenced

week 15

Week 15 — steel frames complete and precast floors, stairs & roofs in progress

Week 12 — block A steel complete block B commenced

Week 10 — block A steel in progress



Week 9 — roads complete steel commencing on block A

Week 8 — ground improvement treatment in progress

Week 4 — foundations being poured

Week 2 — site clearence
